East Lake Station Rehabilitation

south-bridge-eastlake

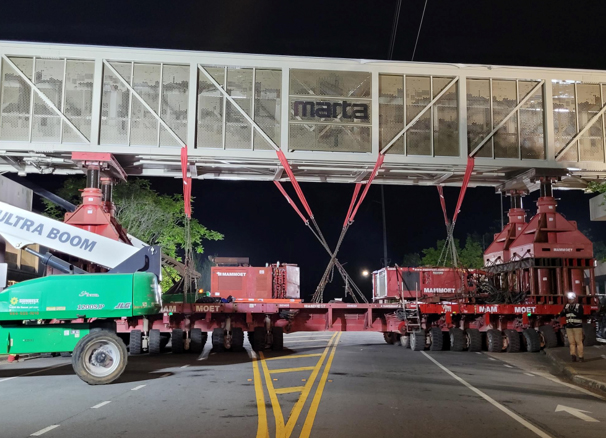

Image description: The image above shows the new south pedestrian bridge at East Lake Station being lowered into place across College Avenue.

RIDER ALERT

South Entrance Closure

The south pedestrian bridge replacement requires the closure of the south entrance, parking lot, and pedestrian bridge for approximately three months.

As of Monday, March 9, 2026:

  • Station Access: All customers must use the north entrance. North elevator remains in service.
  • Buses: Route 34 has been rerouted to the north side. Routes 2 and 19 no longer serve East Lake Station after the NextGen Bus Network launch on April 18, 2026. Details are available at itsmarta.com/nextgen2.
  • Free Shuttles: A shuttle will run between the north and south lots during service hours for customer convenience. The shuttle is free and ADA-accessible.

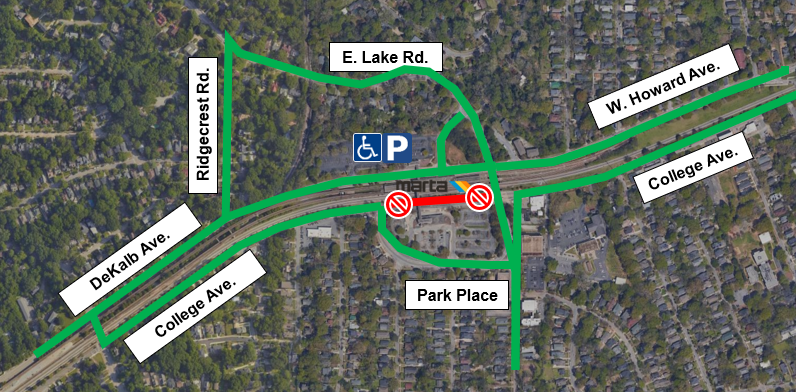

  • Parking: The south parking lot is closed. Parking is available in the north lot. We anticipate ample parking for daily use, but it may fill up during special events.
  • MARTA Reach: MARTA's new on-demand service for the 302 - Kirkwood/Candler Park Zone operates out of the north lot. For more information visit  itsmarta.com/reach.
  • Station Soccer: Both pitches and parking will remain available and accessible during construction.

    EL-SouthBridge-SocialAds_1080x1080_041826

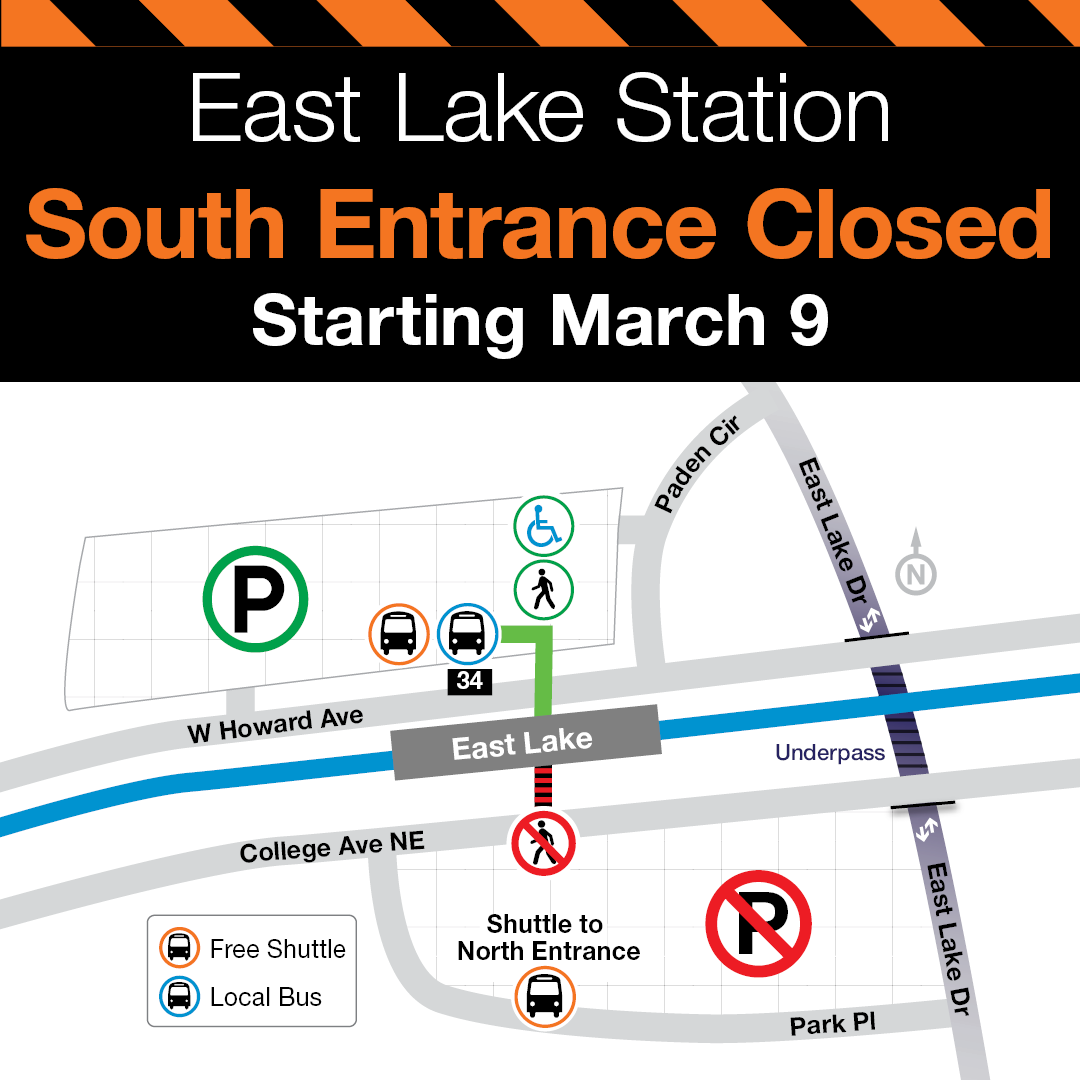

    Image Description: The map above shows the south entrance, parking, and bridge closure. Bus Route 34, parking, and elevator access is open on the north side of East Lake Station. A shuttle runs between sides.

    Partner Toolkit

    The toolkit includes sample project communications, graphics, and images for the south entrance closure.

    Access Partner Toolkit

    Continued  the bridge floor on the north end_cropped 2

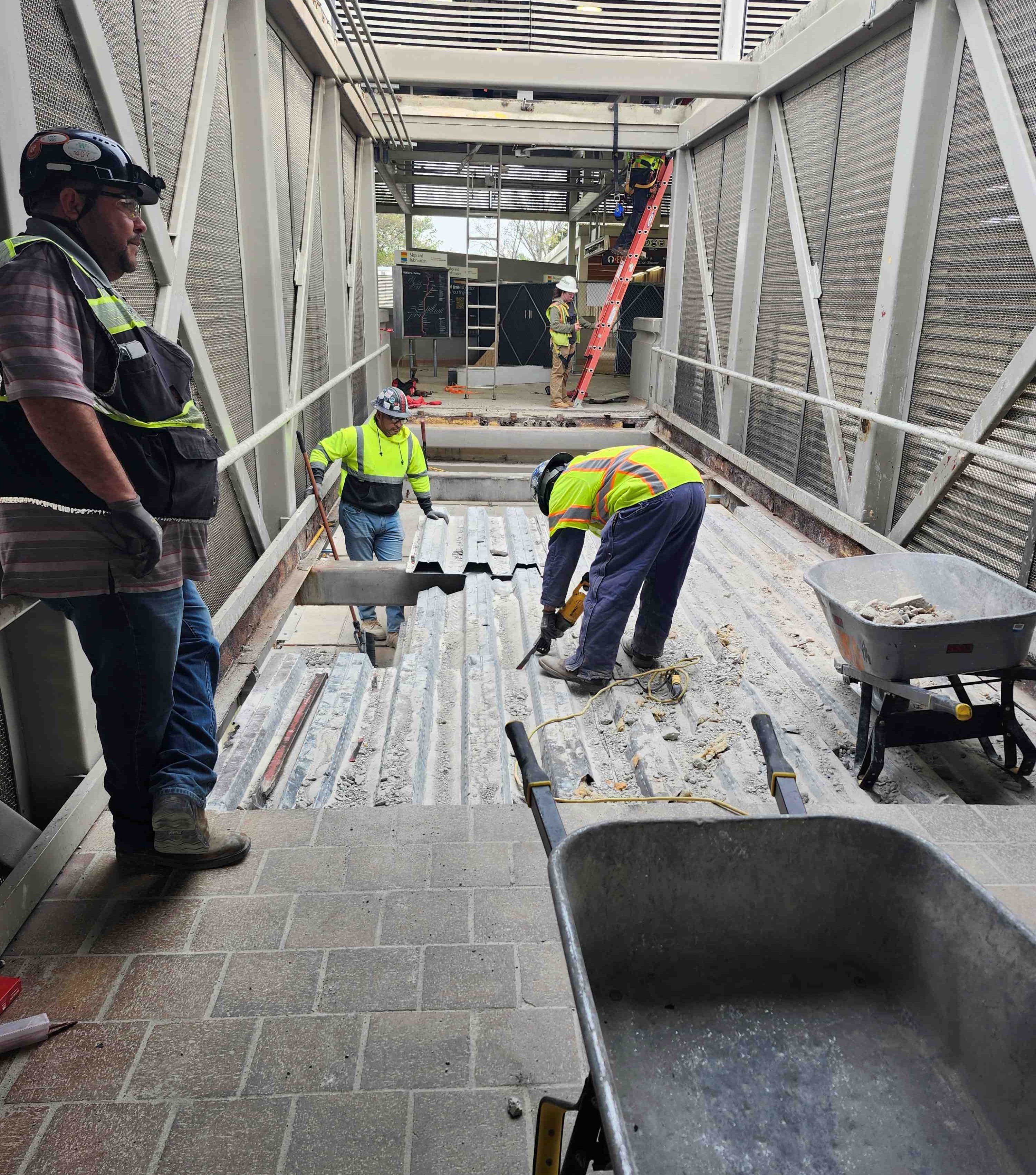

    Image description: The image above shows demolition of flooring on the old south pedestrian bridge.

    Current Status

    Construction.

    Construction for the replacement of south bridge began on March 9, 2026. Estimated completion will be in late May 2026.

    Construction on the north side of East Lake Station is complete. The new north bridge and new north elevator have opened, making the north entrance fully ADA accessible.

    Overview

    East Lake Station opened in 1979 and is one of the first stations being renovated under MARTA’s Station Rehabilitation Program. Renovations include a new pedestrian bridge and new elevator on the north side along with a new pedestrian bridge on the south side.

    Project Features:

    • New elevator on north side of the station
    • New cleaner, safer pedestrian bridges on north and south sides
    • Parking lot improvements with resurfacing, striping, ADA improvements, light poles, and surveillance cameras

    Interior Elevator Horizontal

    Image Description: An interior image of the new north elevator. The interior of the cab has floor to ceiling windows allowing sunlight to stream in along with new doors and railing

    Stay Informed

    Sign up for email updates!

    Please submit comments or questions regarding the project to:

    Antario Williams

    Senior Project Manager
